Skip to main content
Same day service across Sydney.Call 0404133082

Interior painting in Sydney

Interior painting for Sydney homes and offices

Walls, ceilings, doors, skirting and architraves, one room or the whole house. Surfaces are filled, sanded and primed before a topcoat goes near them, and the work is staged so you can keep using the rooms nobody is in.

Licensed and insured. Same day service.

Interior painting for Sydney homes and offices

How a week of interior painting runs in an occupied house

  1. Day one, before anything

    The room is emptied to the middle

    Furniture comes off the walls and into the centre under cover, curtains, wall hangings and switch plates come down, and drop sheets go over the floor. A room that is half cleared gets painted around, and you can see where afterwards.

  2. Then

    Wet areas get a sugar soap wash

    Kitchens, bathrooms and laundries carry cooking grease and soap film, and paint will not bond to either. Everywhere else gets a dust off, because a roller picks up whatever is sitting on the wall and carries it through the coat.

  3. Next

    Fill, sand and caulk

    Nail holes, dents and chipped corners are filled and sanded flush. In a house somebody is living in, the filling for a whole floor tends to be done in one hit and the sanding in another, because it is the dust that decides how much of the house is out of action, not the paint. The gap where the trim meets the wall takes a bead of flexible sealant once that sanding is finished, since caulk is the one thing on a wall you cannot sand back.

  4. Before any colour

    Seal the patches, block the stains

    Fresh filler and bare plaster drink a topcoat and dry to a different sheen, so every patch is spot primed. A water stain needs a stain blocking sealer, because ordinary paint lets it bleed back through within weeks.

  5. First coat

    Ceilings, then walls, then trim

    The work runs top down so anything that drips lands on a surface that is not finished yet. Edges are cut in by brush and the field is rolled into the wet edge before it sets, which is what stops the join showing from the doorway.

  6. Second coat, and after

    The room goes back together

    Two coats is standard on a repaint. Walls are touch dry within a couple of hours, but the film keeps hardening for days, so furniture stays off the walls overnight and anything hung on them waits longer than that.

Three ways an interior job gets staged

The preparation is the same in all three. What changes is how much of the house is out of action at once, and for how long.

A bedroom, a living room or a hallway on its own. The room is cleared into the next one, painted, put back, and then the next room starts. Nothing else in the house stops.

What it suits. A house with children, pets or somebody working from home, where losing the whole place for a week is not on. It is the slowest way to paint a house and the easiest one to live through.

What to watch. Colours signed off one room at a time drift. If the hallway and the bedrooms are meant to match, decide them together and brush the colour out on one wall before any of it is committed.

Local conditions

What a Sydney home adds to an interior job

  • Humidity stretches the drying

    Through a humid February the wait between coats gets longer, not shorter. Recoating early drags the first coat and traps solvent in the film, and the sheen ends up uneven across the wall.

  • Terraces and semis

    Narrow stairs, a shared wall and no side access. Furniture cannot always leave the room, so it is stacked and covered in the middle and the room is worked around it.

  • Strata blocks

    Lifts have to be booked, the by laws set the hours work can be noisy, and common area colours need the committee. That lead time belongs in the quote, not in a surprise on the morning.

  • Older plaster, older trim

    Lath and plaster cracks along the lath lines and sounds hollow when you tap it, so a crack there is filled as a movement crack. The oil based enamel on old trim has to be sanded to a key before anything water based will hold on it.

  • Wet areas that do not vent

    A bathroom with no window grows mould in the corners and across the ceiling. It is treated rather than painted over, or it comes back through the new coat inside a season.

  • West facing rooms in summer

    A west facing room in January gets hot enough to flash a wall coat off before it can be rolled out, so those rooms are done in the morning and the east facing ones after lunch.

Inside work, room by room

A living room back in one even colour, cut in at the cornice and rolled out to the skirting.
A living room back in one even colour, cut in at the cornice and rolled out to the skirting.
Hallway trim, where the brush work is slow and every join shows if it is rushed.
Hallway trim, where the brush work is slow and every join shows if it is rushed.

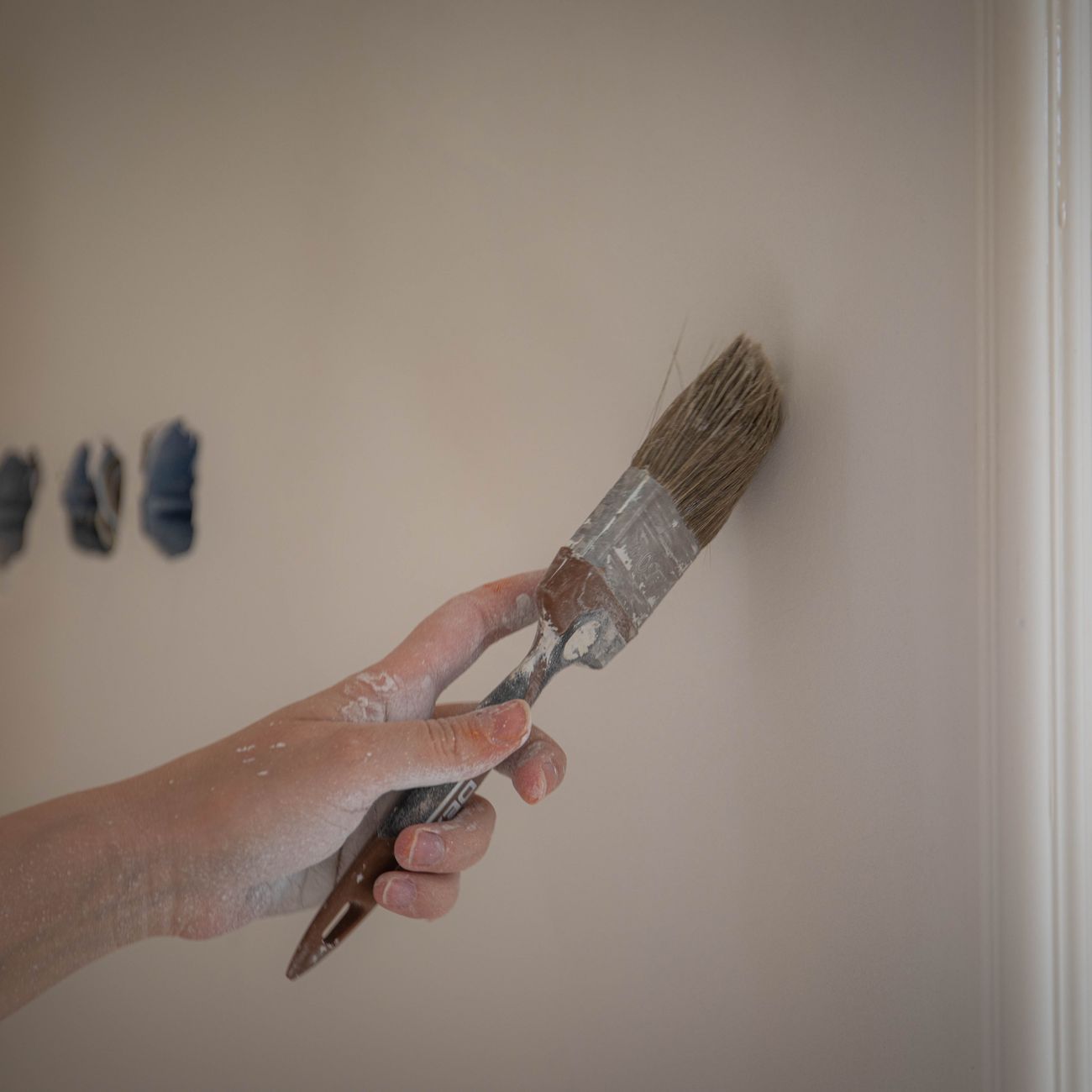

Cutting in by hand along an edge, which is the slow half of any room.
Cutting in by hand along an edge, which is the slow half of any room.
A bedroom finished in two tones, with the change of colour landing on a clean line.
A bedroom finished in two tones, with the change of colour landing on a clean line.

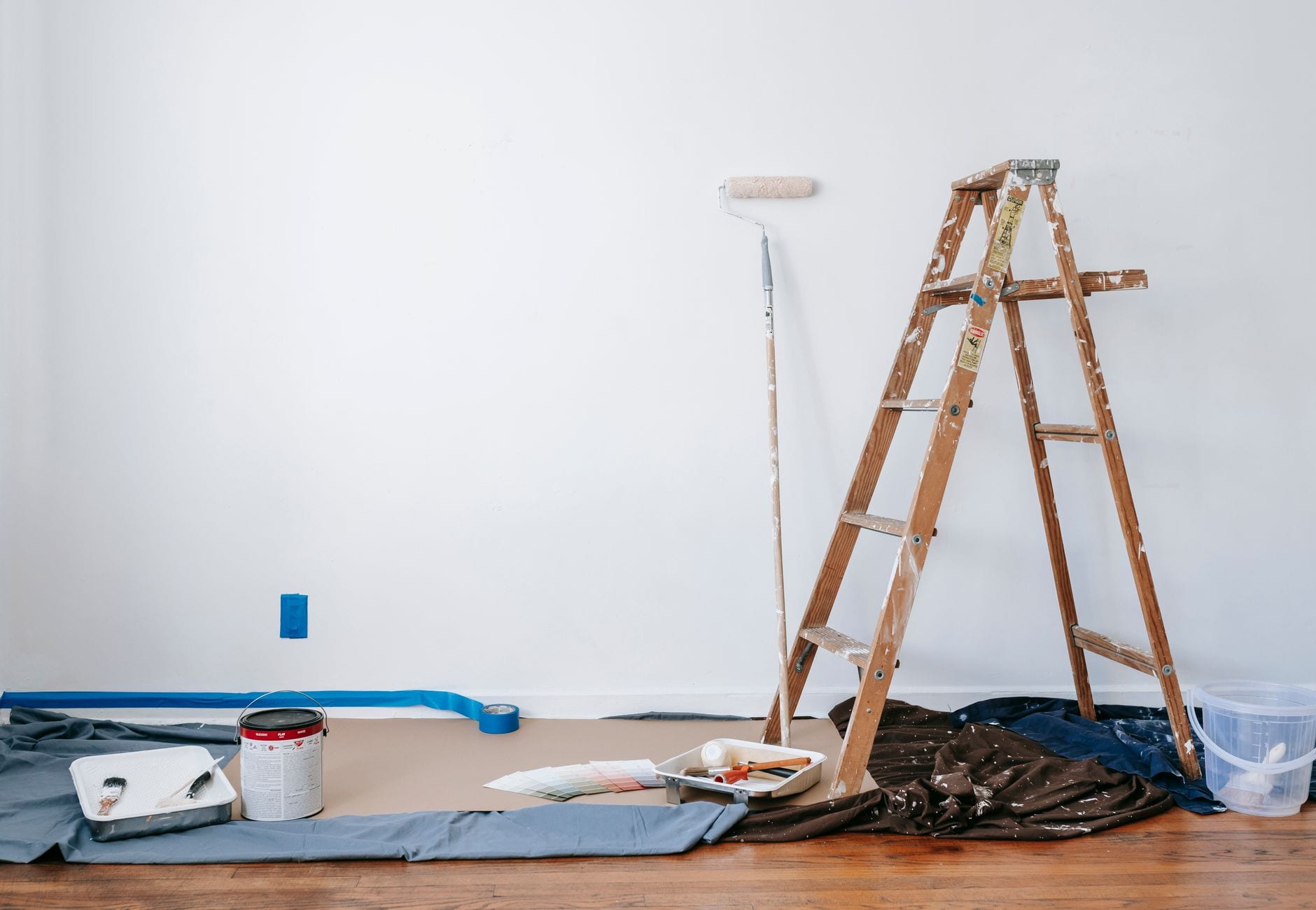

Trays, sheets and tape out before a lid comes off, which is most of the first morning.
